Value Stream Mapping for Steel Manufacturing: From Coil Order to Finished Shipment Without the Reheat Furnace Bottleneck

[pac_divi_table_of_contents included_headings=”off|on|on|on|off|off” scroll_speed=”2100ms” active_link_highlight=”on” marker_position=”outside” title_container_bg_color=”#1FE0BA” open_icon_color=”#000000″ close_icon_color=”#000000″ allow_collapse_minimize_tablet=”on” allow_collapse_minimize_last_edited=”off|desktop” default_state_tablet=”closed” default_state_phone=”closed” default_state_last_edited=”on|tablet” _builder_version=”4.27.2″ _module_preset=”default” title_text_color=”#000000″ sticky_position=”top” sticky_limit_bottom=”section” global_colors_info=”{}”][/pac_divi_table_of_contents]

Steel manufacturing is a capital-intensive process industry. Furnaces, casters, rolling mills, finishing lines and material-handling systems represent substantial fixed investment, while energy, alloys, labour and maintenance add significant operating cost. In this environment, improving isolated machine efficiency is not enough. The commercial result depends on how smoothly the entire value stream converts a customer order into an acceptable, on-time shipment.

Value Stream Mapping (VSM) makes that end-to-end performance visible. It connects the flow of information and material from order entry through slab casting, reheating, hot rolling, cold rolling, finishing, inspection and dispatch. More importantly, it exposes where capital is trapped in work in process, where customer orders wait, and where a constraint limits total throughput.

This guide presents an illustrative steel mill case with 22,000 tonnes of monthly demand, a 34-day average order-to-ship lead time, and a reheat furnace operating at 87% utilisation. The figures are worked examples for improvement planning; each mill should validate its own baseline through a Gemba walk and verified production data.

1. Define the Steel Value Stream Before Drawing the Map

A steel mill may contain several product families with different routes. Mapping the entire site at once usually creates an overly complex diagram. Begin with a high-volume family of customer coil orders that follows a consistent route:

Customer order entry → slab casting → reheat furnace → hot rolling → cold rolling → finishing and processing → inspection → dispatch

The scope should include both material flow and information flow:

  • Customer orders, forecasts and specifications
  • Production planning and campaign schedules
  • Furnace and rolling-mill sequencing
  • Quality release decisions
  • Inventory movement and dispatch instructions

The Voice of the Customer should be translated into measurable CTQs, such as:

  1. Order-to-ship lead time: target below 20 days
  2. On-time delivery: at least 95%
  3. First-pass yield: at least 96%
  4. Surface, gauge and dimensional compliance
  5. Correct grade, width, thickness and coil quantity
  6. Reliable shipment documentation

The Voice of the Business must also be represented. The mill needs strong asset utilisation, controlled energy consumption, stable throughput and acceptable working capital. A future-state design must balance these priorities with customer expectations rather than maximising one metric in isolation.

2. Current-State Map: Where the 34 Days Go

The current-state map should be constructed from observation, production records, ERP transactions, inventory counts and interviews with operators, planners and quality staff. A practical data box for each process includes:

  • Cycle or processing time
  • Changeover time
  • Availability and utilisation
  • First-pass yield
  • Batch or campaign size
  • WIP before and after the process
  • Daily demand and available production time

The representative current-state baseline is:

  • Monthly demand: 22,000 tonnes
  • Average daily demand: approximately 733 tonnes
  • Average order-to-ship lead time: 34 days
  • Value-added processing time: 4.2 days
  • Waiting and queue time: 29.8 days
  • Reheat furnace utilisation: 87%
  • First-pass yield: 91%
  • On-time delivery: 82%
  • Observed WIP across the route: approximately 17,100 tonnes
Process stage Waiting or queue time Value-added processing time Representative WIP
Order entry and production planning 3.5 days 0.2 days 3,500 t
Slab casting 4.5 days 0.7 days 2,800 t
Reheat furnace 7.0 days 0.5 days 4,100 t
Hot rolling 4.8 days 0.6 days 3,200 t
Cold rolling 3.8 days 0.8 days 1,600 t
Finishing and processing 3.2 days 0.7 days 900 t
Inspection and release 2.5 days 0.4 days 400 t
Dispatch staging 0.5 days 0.3 days 600 t
Total 29.8 days 4.2 days 17,100 t

The map indicates that the furnace is not merely a hot piece of equipment; it is the system’s pacing constraint. At 87% utilisation, it has limited recovery capacity for breakdowns, grade transitions and demand variation. Slabs accumulate before reheating, while the hot mill can experience starvation when the required grade, width or temperature condition is unavailable.

A simplified information flow may look like this:

Customer forecast and order → central planning → monthly production plan → weekly campaign schedule → daily furnace and mill instructions → inspection release → dispatch schedule

When every process receives an independent schedule, the system behaves as a push environment. Casting produces to its schedule, reheating produces to its schedule, and rolling produces to its schedule: even when downstream capacity or customer priority has changed.

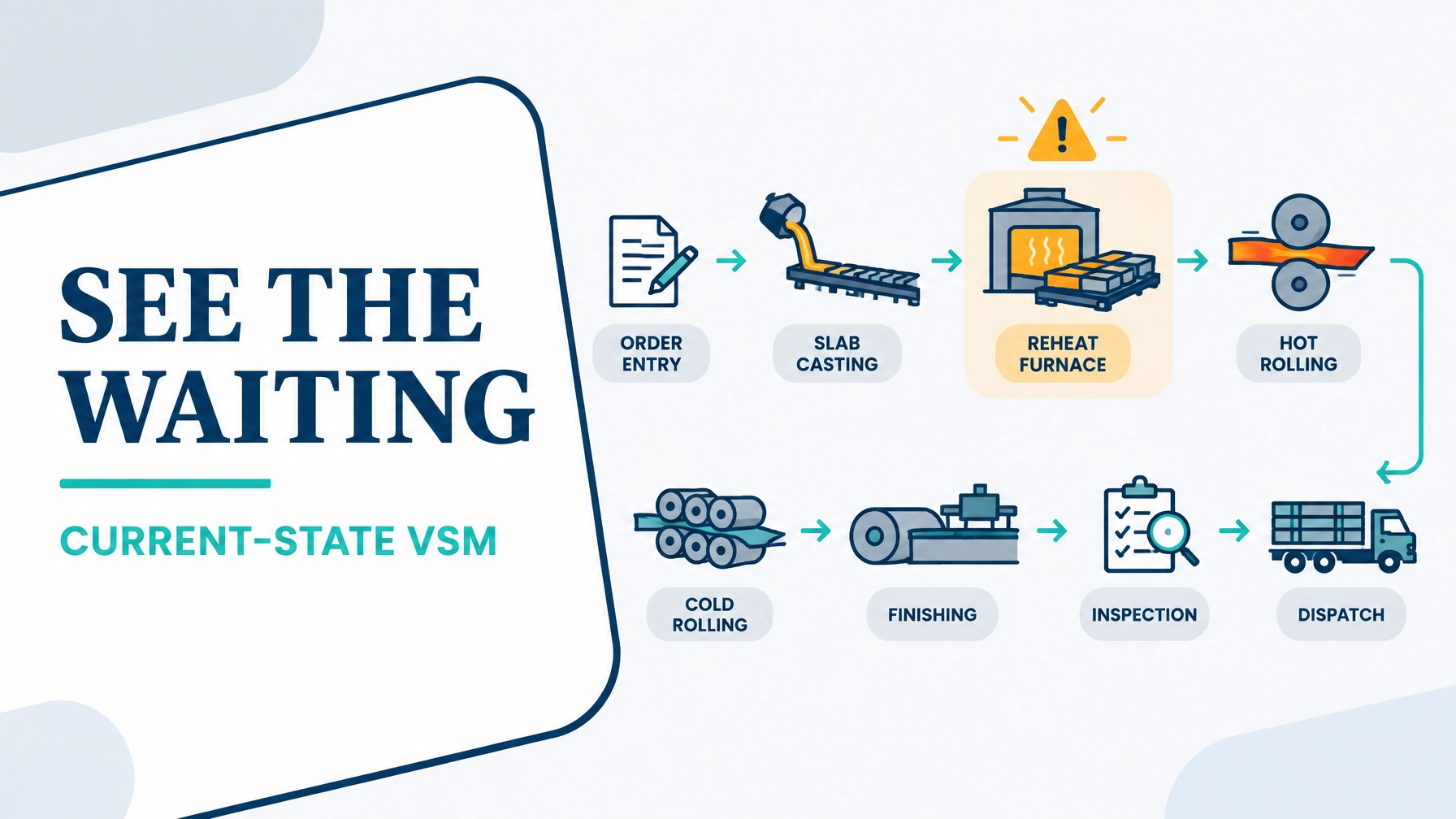

Current-state steel value stream showing the reheat furnace constraint and accumulated queues

3. The Eight Wastes in the Current Steel Flow

The current-state map makes the eight DOWNTIME wastes tangible:

  • Defects: Slab chemistry variation, surface defects, gauge deviations and inspection failures create rework, downgrade or scrap.
  • Overproduction: Large campaigns produce tonnage before confirmed demand or downstream capacity is ready.
  • Waiting: Slabs wait for furnace entry; hot-rolled coils wait for cold rolling; finished coils wait for inspection or transport.
  • Non-utilised talent: Operators spend time expediting orders, searching for material status or correcting schedule discrepancies rather than improving the process.
  • Transportation: Coils and slabs move between storage zones because campaign priorities change after material has already been staged.
  • Inventory: WIP between casting, reheating, rolling and finishing ties up working capital and conceals flow problems.
  • Motion: Planners, quality staff and material handlers repeatedly search systems, paperwork and storage locations for the latest order status.
  • Extra-processing: Duplicate inspections, repeated data entry and additional handling occur when specifications or release rules are unclear.

The Lean Six Sigma Hub process bottleneck analysis guide provides a useful framework for confirming whether the apparent constraint is caused by capacity, changeover loss, downtime, quality loss or scheduling variation.

4. Design the Future State Around the Constraint

The future state should not attempt to make every process run at maximum utilisation. The fundamental purpose is to create a controlled flow that meets customer demand with less waiting, less WIP and fewer quality interruptions.

Campaign scheduling around furnace capacity

Group orders using a deliberate sequence based on:

  • Steel grade and chemistry
  • Slab width and thickness
  • Hot-rolling temperature requirements
  • Cold-rolling route
  • Customer due date
  • Changeover and cleaning requirements

The objective is not simply to create larger campaigns. It is to sequence campaigns so that the furnace is protected from avoidable transitions while downstream orders remain responsive.

SMED-style changeover reduction

Apply Single-Minute Exchange of Die (SMED) principles to roll, guide, tooling, width and product-style changeovers:

  1. Separate internal activities, which require the line to stop, from external preparation.
  2. Prepare rolls, guides, tools and documents before the current campaign ends.
  3. Use standard settings, quick clamps and pre-positioned equipment.
  4. Confirm the next order and material before shutdown.
  5. Measure every changeover with a time observation sheet.

For example, reducing an average hot-mill style changeover from 75 minutes to 30 minutes across 18 monthly transitions recovers 13.5 hours per month. At a constraint rate of 55 tonnes per hour, that represents approximately 743 tonnes of potential capacity.

Flow-based WIP caps

Replace uncontrolled accumulation with explicit WIP limits:

  • Maximum slabs awaiting reheating: 2,200 tonnes
  • Maximum hot-rolled coils awaiting cold rolling: 1,800 tonnes
  • Maximum coils awaiting finishing: 900 tonnes
  • Finished-goods dispatch supermarket: 600 tonnes

When a cap is reached, upstream production does not automatically continue. The team investigates the reason for blocked flow. This is a practical pull discipline that prevents the furnace and rolling mills from becoming storage mechanisms.

Furnace sequencing and pacemaker control

The reheat furnace should become the protected pacemaker for the upstream-to-hot-rolling segment. A daily sequence should consider:

  • Furnace loading pattern
  • Grade and width transitions
  • Required rolling temperature
  • Hot-mill availability
  • Downstream customer priority
  • Planned maintenance windows

Visual controls, Andon escalation and a defined reaction plan should identify furnace temperature deviations, slab delays, unplanned stops and quality risks in real time.

Future-state steel value stream with campaign scheduling, pull controls and capped WIP

5. Current State Versus Future State

The following targets represent a realistic improvement horizon after stabilisation and several focused kaizen events. They are not a substitute for a validated capacity model.

Metric Current state Future-state target Improvement
Monthly shipped tonnage 22,000 t 22,000–24,000 t Demand met with recovery capacity
Order-to-ship lead time 34 days 18 days 47% reduction
Value-added processing time 4.2 days 3.8 days Reduced handling and rework
Waiting and queue time 29.8 days 14.2 days 52% reduction
Total WIP 17,100 t 8,500 t 50% reduction
Reheat furnace utilisation 87% 80–82% stable range More resilience
Hot-mill style changeover 75 minutes 30 minutes 60% reduction
First-pass yield 91% 96% +5 percentage points
On-time delivery 82% 95% +13 percentage points

The improvement in furnace utilisation deserves attention. A lower utilisation percentage can represent better performance when it reflects reduced waiting, fewer emergency sequences and greater protection against variation. A constraint operating predictably is more valuable than a constraint operating continuously at its limit.

6. Kaizen Sequencing: Five Priority Bursts

The improvement sequence should follow the logic of the constraint and the flow:

  1. Kaizen Burst 1 : Confirm the furnace constraint and stabilise daily control

    • Validate capacity by grade, width and campaign.
    • Establish an hourly furnace plan and Andon escalation.
    • Expected impact: reduce schedule-related waiting by 2–3 days and improve visibility of lost capacity.
  2. Kaizen Burst 2 : Reduce rolling and finishing changeovers

    • Apply SMED to tooling, guides, rolls, coil preparation and documentation.
    • Target hot-mill changeovers from 75 to 30 minutes.
    • Expected impact: recover approximately 13.5 hours per month and support smaller campaigns.
  3. Kaizen Burst 3 : Install WIP caps and FIFO control

    • Mark physical FIFO lanes and define maximum quantities at each decoupling point.
    • Escalate any breach within the same shift.
    • Expected impact: reduce total WIP by 25–35% during the first implementation cycle.
  4. Kaizen Burst 4 : Improve furnace sequencing and information flow

    • Link customer due dates, grade families and rolling requirements in one visual schedule.
    • Freeze the near-term sequence except for defined escalation conditions.
    • Expected impact: improve on-time delivery by 6–8 percentage points.
  5. Kaizen Burst 5 : Build quality at source

    • Standardise slab and coil acceptance criteria.
    • Use first-pass yield by grade, shift and campaign.
    • Introduce root-cause reviews for recurring surface, gauge and chemistry defects.
    • Expected impact: raise first-pass yield from 91% to 96% and remove avoidable rework queues.

Steel improvement team converting production data into a controlled future-state flow

7. Control the Gains Through DMAIC

This VSM fits naturally into the DMAIC framework:

  • Define: establish the product family, scope and CTQs.
  • Measure: validate lead time, WIP, changeovers, utilisation and first-pass yield.
  • Analyse: use Pareto charts, process data, takt comparison, 5 Whys and capacity analysis to confirm root causes.
  • Improve: implement campaign scheduling, SMED, WIP caps and furnace sequencing.
  • Control: sustain the gains with visual management, standard work, daily reviews and control charts.

Use the Process Cycle Efficiency Calculator to quantify the relationship between value-added time and total lead time. For project governance, the Business Case Financial Calculator can connect lead-time reduction, recovered capacity and inventory release to financial outcomes.

A steel mill does not need to choose between operational discipline and commercial responsiveness. A well-designed future-state map creates both: a stable constraint, shorter queues, better quality and more reliable shipments.

Build the capability to map, analyse and improve complex value streams. Enrol in Lean 6 Sigma Hub’s CSSC-accredited Lean Six Sigma Black Belt training and learn to lead measurable improvement across capital-intensive operations.

Kaizen. Kai-Care. Kai-Done. ( Lean Six Sigma)
